Why This Page Exists
Most homeowners meet foundation repair methods through a sales proposal. Someone arrives, looks at the house, and recommends a system — usually the system that company installs. The homeowner has no independent basis for judging whether that recommendation fits the property.
This page is that basis. It explains the main systems used in foundation repair around Houston, how they actually work, what each does well, and what each does not do well, so you can read a proposal critically. It is educational. For a property-specific recommendation you need an evaluation, because methods are not selected from a symptom, a home’s age, or a ZIP code.
The Principle Behind All of Them: Underpinning
Every system here is a form of underpinning. The concept is the same in each case.
The original foundation bears on soil near the surface. That soil has proven unable to provide consistent support — it swells and shrinks with moisture, it has eroded, it was poorly compacted, or it has been desiccated by tree roots. Underpinning establishes support at greater depth, where conditions are more stable, and transfers load to it.

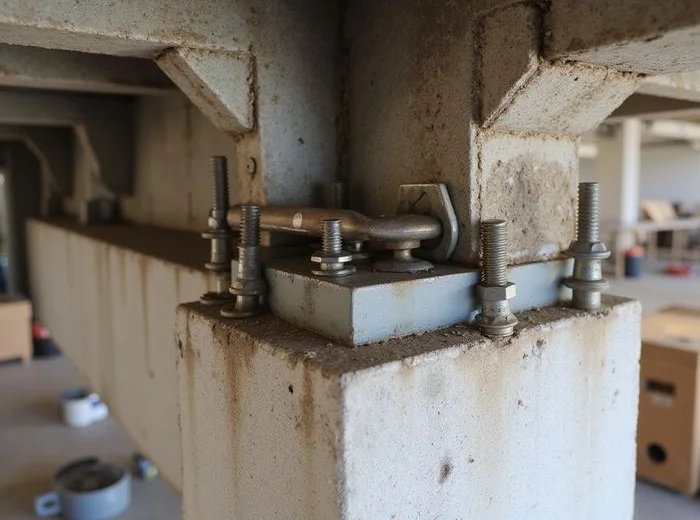

The load path runs from the structure, through a pier bracket or cap bolted to the grade beam, down the pier shaft, to the bearing layer. That bracket connection is what actually transfers the load, so its condition and the connections holding it matter as much as the pier itself. What varies between systems is how the shaft is formed, how depth is determined, and how bearing is achieved — end bearing on a resisting layer, skin friction along the shaft, or a widened base spreading load across more soil.
Stabilization and lifting are related but distinct objectives, and a proposal should say which one it is targeting. Foundation stabilization versus lifting is a real distinction: stabilization stops further movement by establishing reliable support at each pier location, while lifting goes a step further and recovers position, raising the structure back toward a target elevation. Some projects only need stabilization. Others need both.

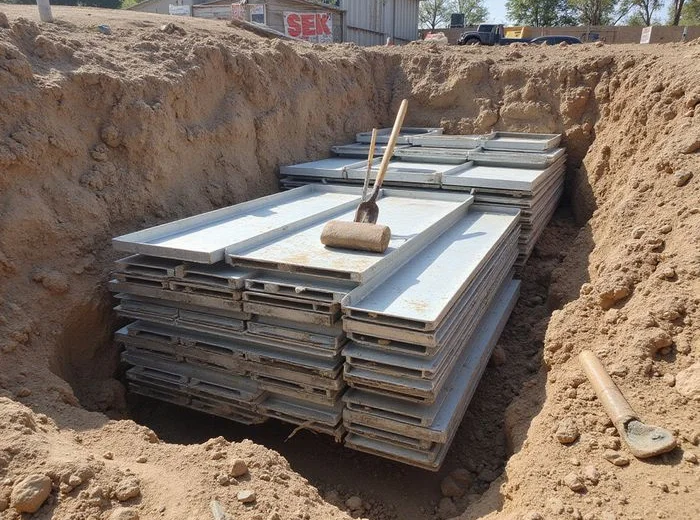

Driven Steel Piers

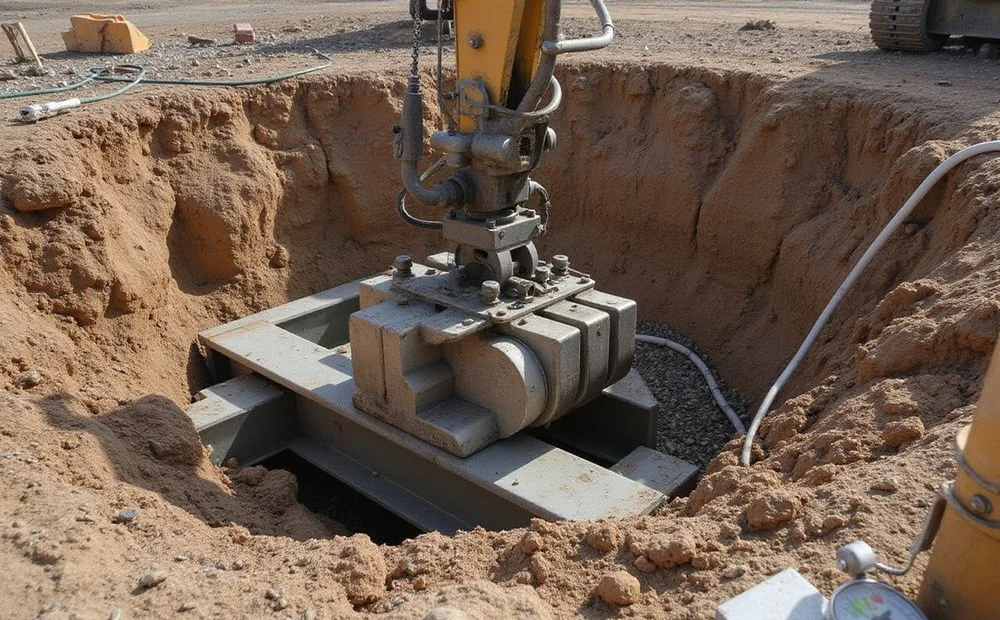

Steel pier sections are advanced into the ground hydraulically, using the structure’s own weight as reaction, until the pier meets refusal.
How depth is determined: by the soil. The pier advances until resistance reaches a threshold. Depth is discovered during installation, not decided beforehand. Two piers ten feet apart can reach refusal at different depths, and that is normal.
Strengths: reaches deep bearing layers where they exist. Installation is relatively clean with modest excavation. Suits tight access. Installation pressure provides real-time feedback about what the pier is encountering.
Limits: premature refusal on an obstruction — a buried slab, debris, an old footing — can be mistaken for genuine bearing if nobody is paying attention. Corrosion protection matters in aggressive soils. Cost rises with depth and depth is not knowable in advance.
More detail in the steel pier systems guide.

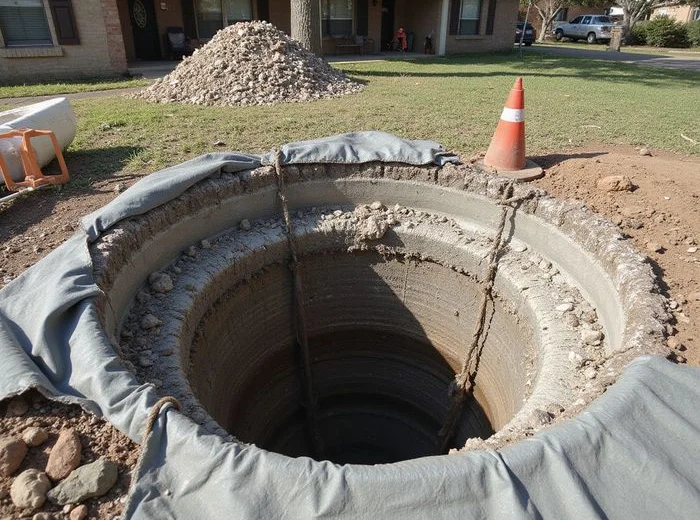

Drilled Bell-Bottom Concrete Piers
A shaft is drilled to a planned depth, the base is belled out to a wider diameter, reinforcement is placed, and the pier is poured in place.
How depth is determined: planned in advance from local knowledge and any geotechnical information available, rather than discovered during driving.
Strengths: the widened base spreads load across more soil at the bearing depth. Cast in place, so the shaft conforms to the excavation. Well established in Houston-area clay.
Limits: requires room to drill and handle spoil. Cure time before the pier can take load. Depth is a judgement made in advance rather than confirmed by resistance. Groundwater complicates the excavation.
More detail in the concrete pier systems guide.

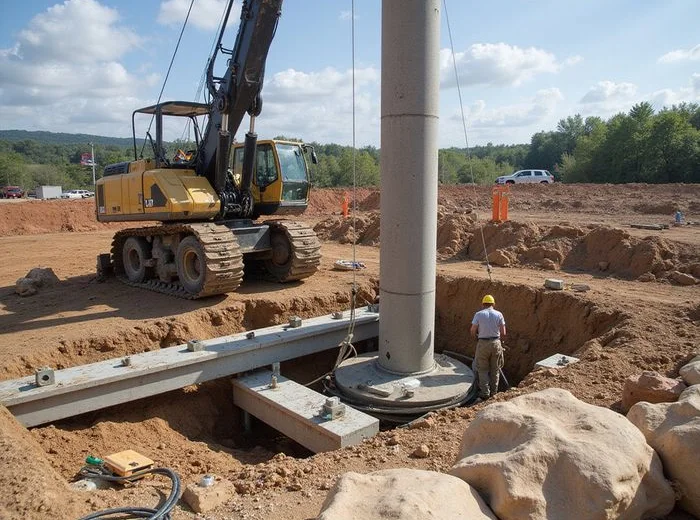

Pressed Concrete Pilings
Precast concrete cylinder segments are driven hydraulically in sequence, using the structure’s weight as reaction, until resistance is reached.
Strengths: fast, comparatively clean, and cost-effective where conditions suit. No cure time before loading. Modest excavation footprint.
Limits: less depth control than a driven steel system and no widened bearing base. Segments can misalign if not driven carefully. Suited to conditions where the bearing layer is within reach of the available driving force.
How a Method Actually Gets Selected
In that order, every time.
- Elevation survey and distress mapping. Where is the floor plane out, by how much, and in what pattern? This determines whether repair is warranted at all and where support is needed.
- Site conditions. Soil indications, likely bearing depth, drainage, tree proximity, previous repair, and any geotechnical information available.
- Structural factors. Foundation type, load at each proposed location, and whether the slab is post-tensioned.
- Practical constraints. Access for equipment, side-yard width, hardscape, pools, easements, and how the site must be left.
- Method selection, with reasoning stated in the proposal.
- Layout, driven by where support is needed rather than a uniform perimeter count.
A uniform pier count applied to a perimeter regardless of the survey is a sales template, not an engineering response.
What No Method Does
Worth stating plainly, because the marketing rarely does.
- No pier stops clay from moving. Expansive soil between and around pier locations continues to swell and shrink with moisture.
- No repair resolves regional subsidence. That is a regional phenomenon measured by USGS and the subsidence districts, and no residential system addresses it.
- No repair resolves fault-related ground movement. Published fault traces describe regional geology. A proposal claiming a system resolves fault movement is overreaching.
- No system is permanent. A written warranty describes coverage at the locations installed, with its limits stated. It is not a promise the property will never move.
- Uplift acts on pier shafts too. Expansive soil pushes up on the shaft, not just on the slab, which is why installation detailing matters.
Questions Worth Asking Any Contractor
- Why did you select this system for my property specifically?
- What does this system not do well here?
- What is the pier count based on, and what does the elevation survey show?
- Is depth determined by refusal, or is it planned?
- Will you record installed depth and pressure at each location?
- How would you distinguish genuine refusal from an obstruction?
- What does the warranty cover, and what does it exclude?
Our comparison worksheet turns these into a structured checklist you can apply to every proposal you receive.
Where to Go Next
If you are evaluating proposals, read the steel versus concrete piers comparison. If you want to know what your property actually needs, that comes from an evaluation, not from a page.
